Decision Guide
Software Development Subscription vs Fixed-Price Development
Fixed-price software projects and development subscriptions solve different procurement problems. This guide compares how each model handles scope, changing priorities, budget, delivery continuity and risk.
Businesses often compare software providers before deciding how the work itself should be purchased. A fixed-price project provides a defined scope and agreed total price, while a development subscription provides recurring capacity for ongoing and evolving requirements.
This decision guide helps UK buyers evaluate scope certainty, change frequency, cost predictability, procurement effort, continuity, internal management, delivery risk and suitability over time—without assuming one model is universally better.
What Is the Difference Between a Software Development Subscription and a Fixed-Price Project?
A fixed-price project agrees a defined scope, delivery plan and price before development begins. A software development subscription provides recurring delivery capacity that can be reprioritised as requirements evolve.
Fixed-price is generally better for stable, one-off requirements. A subscription is generally better for ongoing work where priorities and requirements are expected to change.
A fixed-price project purchases a defined outcome, while a development subscription purchases recurring delivery capacity.
What Is Fixed-Price Software Development?
In fixed-price software development, requirements are defined before agreement. Deliverables are documented, the price is agreed against that scope, and milestones with acceptance criteria are normally set. Changes may require a formal variation. The provider carries estimation risk within the agreed scope; the client carries risk if requirements were incomplete or misunderstood.
Strengths
- Clear approved budget against a defined scope
- Documented deliverables and acceptance criteria
- Easier procurement approval for one-off work
- Suitable when requirements are stable
- Clear completion point for stakeholders
Limitations
- Change requests can add delay and cost
- Extensive discovery is required upfront
- Early assumptions may become constraints later
- New priorities are harder to introduce mid-delivery
- Suppliers may protect margin by interpreting scope narrowly
What Is a Software Development Subscription?
A software development subscription provides an agreed amount of recurring monthly delivery capacity. Work is clarified, estimated and prioritised through a shared backlog, allowing priorities to change without creating a new project agreement for every requirement.
Delivery typically covers prioritisation, development, QA, release and reporting, with continued product context across monthly cycles. See Software Development as a Subscription for UK Businesses for the commercial service model.
A development subscription is not unlimited delivery. Capacity remains finite and work must be prioritised.
Strengths
- Recurring capacity for ongoing improvements
- Shared backlog and visible prioritisation
- Fewer repeated procurement cycles for new work
- Retained product and architecture context
- Suitable when priorities change over time
Limitations
- Capacity remains finite and must be prioritised
- Predictable fees do not guarantee equal monthly output
- Unclear requirements still consume capacity
- Requires recurring client decision-making
- Large one-off builds may still need a project phase

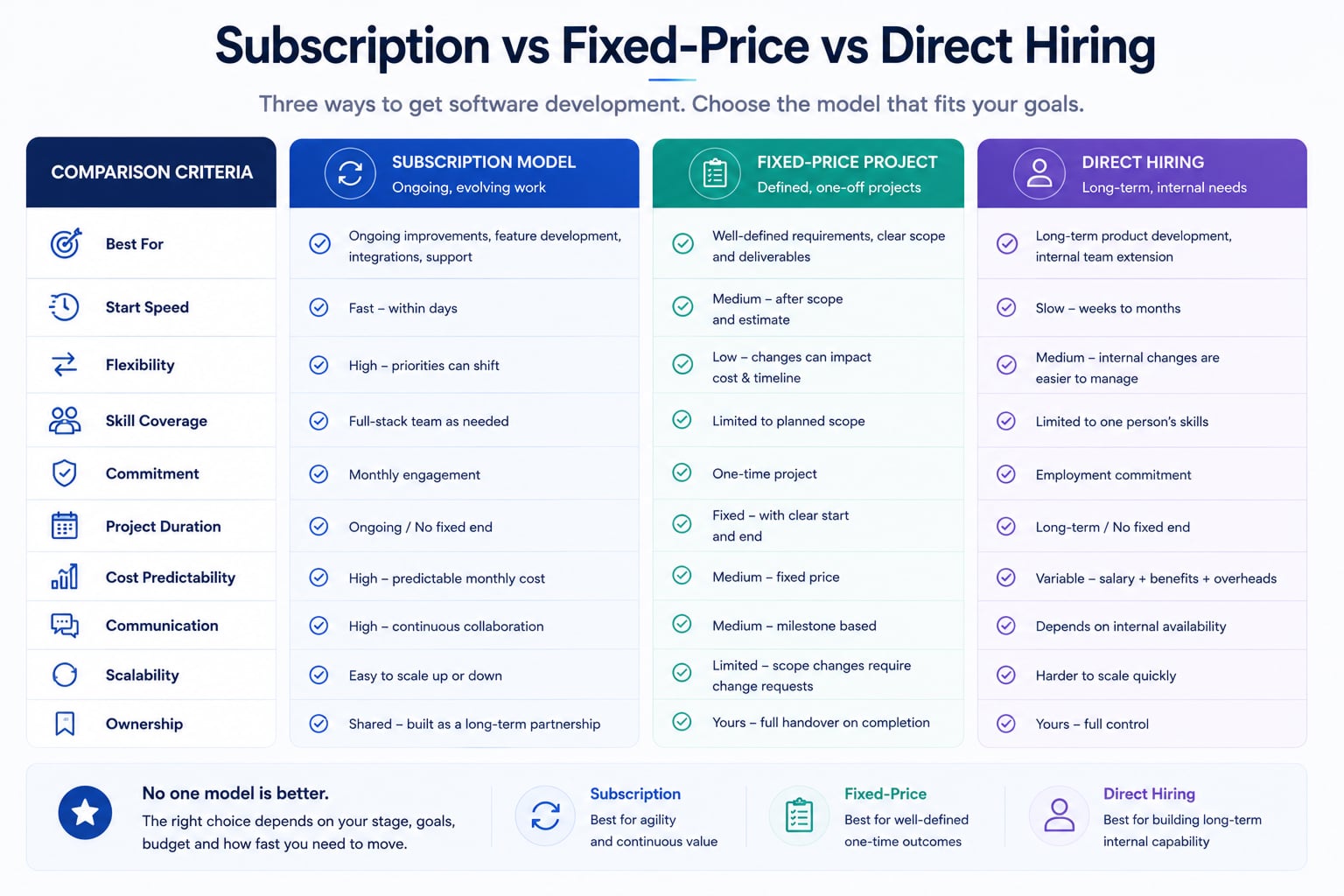

Software Development Subscription vs Fixed-Price: Side-by-Side Comparison
Swipe sideways to compare all columns
| Aspect | Fixed-price | Subscription |
|---|---|---|
| Best suited to | A defined project with stable deliverables | Ongoing development needs and evolving backlogs |
| Scope | Agreed upfront against documented requirements | Shared backlog that evolves over time |
| Budget structure | Total project price for the agreed scope | Recurring monthly fee for agreed capacity |
| Requirements changes | Usually handled through change control | Priorities can shift within available capacity |
| Procurement | Proposal, quote and approval for each project | Continuing commercial relationship after onboarding |
| Start of new work | Often waits for a new agreement cycle | New items enter the existing backlog queue |
| Delivery continuity | Ends when the project completes | Continues through monthly delivery cycles |
| Product knowledge | Built for the project; may reset later | Builds across months of retained context |
| Prioritisation | Locked to the approved project plan | Reviewed regularly against capacity |
| Completion point | Clear end date and acceptance criteria | No single endpoint; work continues while needed |
| Client involvement | Strong upfront decisions, then acceptance reviews | Recurring priority decisions and feedback |
| Provider risk | Estimation risk within the agreed scope | Delivery risk managed through capacity and prioritisation |
| Typical engagement length | Finite project duration | Continuing monthly engagement |
| Handover | Usually at project completion | Ongoing documentation plus structured exit handover |
Fixed-price purchases a defined outcome. A subscription purchases recurring delivery capacity. Critical conclusions also appear in the sections that follow—do not rely on the table alone.

The table above carries the comparison facts. The visual summarises engagement trade-offs across models; use both together when briefing stakeholders.
How Certain Is the Scope?
Fixed-price works best when requirements are understood, dependencies are known, acceptance criteria are stable, external integrations are predictable, stakeholders agree on outcomes, and material changes are unlikely.
A subscription works better when requirements will emerge through use, priorities may shift, the product is already live, integrations evolve, user feedback influences the roadmap, or work consists of many medium and small items.
The less certain the scope, the harder it is to price a project accurately without either increasing contingency or narrowing interpretation. Uncertainty is normal in evolving digital products—it is a signal about procurement model, not a failure of planning.
How Often Are Priorities Likely to Change?
Under fixed-price delivery, changes require review. They may affect cost and timeline and often need formal approval through change control.
Under a subscription, items can be reordered in the backlog so urgent work moves forward. Other planned work may move back. Capacity does not increase automatically when priorities shift.
Reprioritisation changes the order of work, not the amount of available capacity.
How Much Procurement and Re-Scoping Is Required?
Fixed-price procurement usually involves initial discovery, proposal, scope, quote, approval and contract—then change requests and often a new agreement for later work.
A subscription typically involves initial onboarding and a continuing commercial relationship. New work enters the backlog with fewer repeated procurement cycles, supported by recurring governance and priority reviews.
A subscription does not remove scoping. Clarification and estimation remain necessary for every meaningful item of work.
How Does the Budget Work?
Fixed-price budget is an agreed total project price, often paid against milestones and linked to defined scope. Changes may increase price.
Subscription budget is a recurring monthly fee linked to agreed capacity. Work completed varies by complexity. The engagement cost is predictable; the quantity of features delivered each month is not guaranteed.
A predictable monthly fee does not mean every month produces the same number of features. Complexity, dependencies and review cycles affect delivery.

How Important Is Retained Product Knowledge?
Recurring engagement can preserve business context, architecture knowledge, past decisions, integration history, deployment knowledge, user-feedback context and backlog priorities.
A well-run fixed-price project can still produce strong documentation and handover. Fixed- price teams do not automatically lose knowledge—continuity simply depends on whether the engagement continues after the project ends.
How Much Internal Management Is Needed?
Fixed-price work requires strong upfront decision-making, scope approval, acceptance and change management. Once underway, it may need less weekly prioritisation than a subscription.
A subscription requires recurring priority decisions, a maintained backlog, regular stakeholder access, and timely feedback and approvals. It is not a substitute for client decision-making.
How Do Risk and Accountability Differ?
Fixed-price risks
- Incomplete requirements
- Restrictive scope interpretation
- Contingency pricing
- Change-request disputes
- Delivery pressure near milestones
Subscription risks
- Unclear prioritisation
- Capacity consumed by investigation
- Backlog growth without outcomes
- Lack of clear cycle goals
- Ongoing spend without governance
Good controls for both models include written acceptance criteria, transparent estimates, a visible backlog, regular reporting, documented decisions, QA, change visibility and structured handover.
When Is Fixed-Price Development the Better Choice?
- Clearly defined one-off project
- Stable requirements and known dependencies
- Agreed completion point and acceptance criteria
- Fixed procurement budget for a defined deliverable
- Limited expectation of change during delivery
- Formal tender or fixed-scope compliance requirement
- Isolated migration or integration with predictable endpoints
- Tightly specified prototype
Fixed-price is strongest when the work can be described accurately before development begins.
When Is a Development Subscription the Better Choice?
- Ongoing feature backlog after launch
- Live product improvement and stabilisation
- Recurring integrations and operational changes
- Post-MVP development with evolving priorities
- Regular fixes plus enhancements in one rhythm
- Uncertain monthly demand that still needs continuity
- Need for multiple technical disciplines over time
- Repeated small and medium packages of work
A subscription is strongest when continuity and adaptability matter more than defining a final endpoint upfront.
For practical situations that match this pattern, see practical software development subscription use cases. Explore Software Development as a Subscription for UK Businesses when continuity and adaptability matter more than a fixed endpoint.
Can Fixed-Price and Subscription Development Be Used Together?
Different stages of the same product may require different commercial models. Buyers are not limited to a binary choice—a hybrid sequence often matches how real systems evolve.
- 1Discovery or initial build. Deliver a defined project where the first release can be scoped clearly.
- 2Stabilisation and launch. Complete acceptance, launch support and early defect handling.
- 3Move improvements into a subscription. Shift recurring backlog work into monthly delivery capacity.
- 4Scope major modules separately when needed. Large future modules can still be estimated as defined projects.
- 5Continue routine development monthly. Keep integrations, fixes and iterative features in the subscription rhythm.
- Fixed-price MVP followed by subscription improvement
- Fixed-price rescue audit followed by monthly stabilisation
- Fixed-price migration followed by ongoing integrations
- Fixed-price redesign followed by continuous feature work
Which Software Development Model Should You Choose?
Use these questions to structure a procurement conversation with your team.
- 1.Is the scope stable and documented?
- 2.Is there a clear completion point?
- 3.Will priorities change during delivery?
- 4.Is there an ongoing backlog after launch?
- 5.Can stakeholders approve detailed requirements upfront?
- 6.Is repeated procurement causing delay?
- 7.Is internal product ownership available?
- 8.Does the work require several technical disciplines?
- 9.Is the budget approved as a project or operating expense?
- 10.Is continuity important after initial delivery?
Fixed-price: Choose fixed-price when most answers indicate stable scope and a defined endpoint.
Subscription: Choose subscription when most answers indicate ongoing work, changing priorities and a need for continuity.
Discovery first: Choose discovery first when the answers are unclear because the current system or requirement is not sufficiently understood.
Practical Examples
A defined website migration
- Likely model: Fixed-price
- Reason: Known source, destination, deliverables and completion criteria.
A SaaS product with a growing backlog
- Likely model: Subscription
- Reason: Features, feedback, fixes and integrations continue to evolve.
An unstable legacy application
- Likely model: Discovery first, then possibly fixed-price stabilisation or subscription
- Reason: The amount and nature of the work cannot be assessed safely without investigation.
A new internal business platform
- Likely model: Depends on scope maturity
- Reason: A defined first release may be fixed-price, followed by a development subscription for iteration.
Recurring CRM and automation improvements
- Likely model: Subscription
- Reason: Workflows, integrations and reporting usually expand after the first release.
Single API integration with stable documentation
- Likely model: Fixed-price
- Reason: Endpoints, acceptance criteria and completion point can be agreed upfront.
Related paths include existing application rescue, SaaS product development, and business automation when the workload continues after the first release.
Frequently Asked Questions
Not necessarily. A fixed-price project prices a defined outcome, while a subscription prices recurring capacity. Which appears cheaper depends on scope certainty, change volume, duration and how much re-scoping would otherwise occur. Neither model is universally lower cost.
Yes, but changes usually require review. They may affect cost, timeline and formal approval through change control. That process protects both parties when the original scope was the basis of the price.
No. A development subscription provides finite monthly delivery capacity. Requests can still be added to the backlog, but work must be prioritised against the agreed allocation.
It depends on maturity. A clearly scoped MVP may suit fixed-price delivery. After launch, when feedback creates an evolving backlog, a development subscription is often a better fit. Some startups also begin with discovery when the problem is not yet well defined.
Existing applications often suit a subscription when fixes, integrations and improvements continue month after month. A fixed-price project can still be right for a defined migration, redesign or compliance deliverable with stable acceptance criteria.
Yes, if the first release is expected to evolve quickly and stakeholders can prioritise a shared backlog. If the MVP scope is tightly specified with a clear completion point, fixed-price delivery may be simpler to procure.
In a subscription, items can usually be reordered in the backlog so urgent work moves forward. Other planned work may move back. Reprioritisation changes the order of work, not the amount of available capacity.
Ownership depends on the contract. In a well-structured engagement, clients typically own the custom source code and project-specific assets created for them once applicable invoices are paid. Pre-existing components, open-source software and third-party services remain subject to their own licence terms under either model.
Yes. A common hybrid approach is a fixed-price discovery or initial build, followed by a development subscription for ongoing improvement. Major future modules can still be scoped separately when needed.
Discovery is appropriate when the current system, dependencies or requirements are not understood well enough to price a project accurately or to set realistic monthly capacity. It reduces the risk of locking incomplete assumptions into either model.
Choose the Model That Matches the Nature of the Work
Fixed-price suits defined work with stable scope. A subscription suits recurring and evolving work. Discovery suits unclear or technically risky situations. Hybrid models are often practical. The procurement model should follow the nature of the work, not habit.
1. Read the broader guide
2. Explore monthly development capacity
Continue to Software Development as a Subscription.
3. Ask Primewayz UK to review the workload
We will recommend a subscription, a defined project or a discovery phase based on the nature of the requirement.
Request a Capacity Recommendation
Related content
Software Development as a Subscription
Commercial service page for monthly development capacity in the UK.
Subscription-Based Software Development Guide
Educational pillar covering both meanings of subscription-based software development.
Software development subscription use cases
Ten practical situations where monthly delivery capacity may fit—and where another model may be better.
How monthly development capacity works
Operating mechanics behind finite monthly delivery effort.
Why businesses move to continuous development
Strategic reasons organisations shift beyond isolated projects.
How to choose a software development partner
Practical evaluation criteria for discovery, delivery and ownership.
Fixed-price vs time & material vs subscription support
A practical comparison of delivery models for UK SMEs and SaaS founders.
Why start with a foundation sprint
When discovery and stabilisation should come before monthly delivery.
